Tuesday, November 10, 2009
Construction Update #75

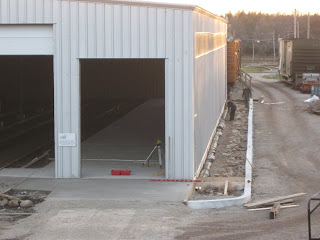

All in all it was a tremendous weekend, and the current phase of the project is substantially complete, 2 weeks ahead of the scheduled completion date published in the August 8 workplan. With the concrete work and track construction complete, we can concentrate on minor deficiencies and cleanup. My sincerest thanks to everyone who has assisted so far. While a lot of work remains to ballast, lift and tamp the yard, and complete the electrical work and parts shelving in the building, we have accomplished the goal of getting the building ready for cars this fall.
Construction Update #74
The final concrete pour took place Saturday morning. The slabs adjacent to track 45 were poured, along with the slabs in front of the doors on the north side of the building. Unfortunately, the load of concrete was about half a meter short of finishing the last door slab so it will be completed with redi-mix. With the concrete pouring out of the way, attention turned to track construction. Track 45's north rail was spiked inside the building, and ties were laid out for tracks 41, 42 and 43 outside. The line and gauge rail were installed on track 42 and 43 before we ran out of light. The line rail was also set on track 41 in preparation for Sunday. Concurrent with the above, the track 46 and #7 switches had the ballast levelled off, and they were tapmed using the air tampers and a rented compressor.
Construction Update #73
Construction Update #72
Thursday was another productive day. The curb form was completed first thing in the morning, as was the catchbasin frame for Track 45. The first concrete truck arrived at 0900, and the curb was poured. The second truck arrived at 1030, and the ramp into the parts area was poured, along with the pad between the rails on Track 45. Once the concrete set up, all of the curb forms were stripped to allow for finishing. As well as being a nice cosmetic detail, the curb performs an important stormwater management function - It retains the cobbles which break up the run-off from the roof, and directs the runoff into the drain pipe along the wall, which in turn carries the stormwater away.
Wednesday, November 4, 2009
Construction Update #71
The face form for the north curb was constructed and installed last night. Remaining is the "Bullnose" form at the east end which is being built today. Arrangements have been made to have the track crew back this coming weekend, and the track will be completed by Sunday night. Work has been progressing at a feverish pace for the past 3 months solid, and the light at the end of the tunnel is blazing bright. Stay tuned for updates as we work through the last few parts of this phase of the project.
Monday, November 2, 2009
Construction Update #70
We had another busy weekend, and the final pieces of the puzzle are falling into place. The forms on the north floor slab were stripped, and flipped over to form the back of the curf. Face forms for the curb will be borrowed from a curb contractor, and the curb will be poured in the next week or so. Track 45 was lifted and blocked through the doorway, and the slab forms were installed along with the track drain pipe. The ramp leading into the parts area was also formed, and is ready to pour. The balance of the slabs will be poured toward the end of this week.
Prep work for track construction was also done, and there is 270 feet left to construct. It is planned to complete this work this coming weekend.
Funds for track material are atill needed - please contribute if you can.
Prep work for track construction was also done, and there is 270 feet left to construct. It is planned to complete this work this coming weekend.
Funds for track material are atill needed - please contribute if you can.
